The 2019 Decision

The Split Record, piece one of twenty-one. A weekly reading of the public record on Vancouver's school lands, published Mondays.

The Split Record, piece one of twenty-one. A weekly reading of the public record on Vancouver’s school lands, published Mondays.

In October and November 2019, while the Vancouver School Board was still publicly listing Sir Guy Carleton Elementary among its seismic priorities, an internal capital commitments table told a different story.

The commitments table

Here is that table, transcribed in full from the document titled Capital Commitments October/November 2019, every figure as it appears.

ItemOriginalRevisedStatus
Hamber Auditorium3,500,0003,500,000Agreed to (not final)
Kitsilano Lawsuit1,000,0001,000,000Estimated
Weir 75% Replacement2,977,8572,977,857Agreed to in CPFA (new build)
Maple Grove986,712986,712Agreed to in CPFA (new build)
Maple Grove, Rooftop300,000300,000Agreed to and communicated to community
Henry Hudson110,2001,062,500Agreed to and communicated to VPO SC
Carleton1,100,0001,895,200To be decided
Total possible commitments9,974,76911,722,269
Agreed to8,827,069

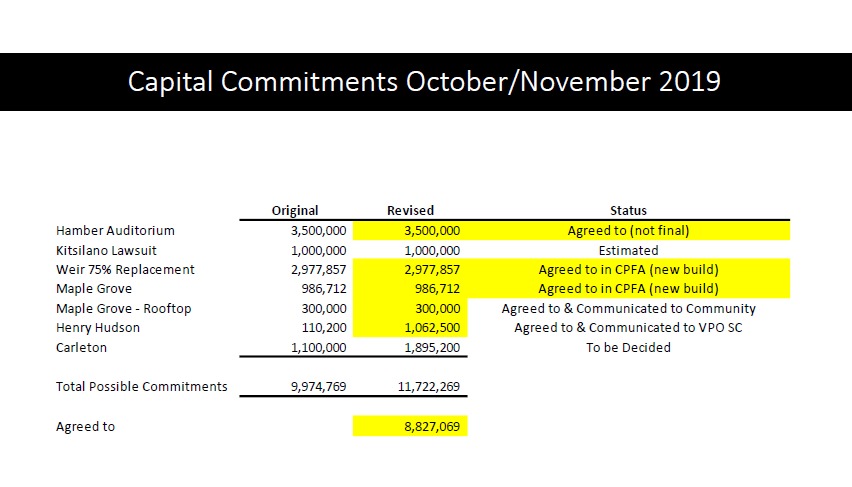

Vancouver School Board slide titled Capital Commitments October/November 2019, showing the seven-line table transcribed above with original and revised columns and a status column. Five lines are highlighted: the Hamber auditorium, Weir, Maple Grove, the Maple Grove rooftop and the agreed-to total of 8,827,069. The Carleton line, at 1,100,000 revised to 1,895,200, is not highlighted and its status reads To be Decided.
Capital Commitments October/November 2019, the source document for the table above. Obtained by VTCo; not published by the district. Provenance is stated in Sources.

The arithmetic, shown as this series always shows it: the revised total of $11,722,269 minus the estimated Kitsilano lawsuit at $1,000,000 and minus Carleton at $1,895,200 equals the agreed-to figure of $8,827,069 exactly. Read that reconciliation slowly, because it is the whole finding. Every project on the list carried an agreed status except two lines, and one of those two was a lawsuit estimate. The other was Carleton. The companion document, a six-year Capital Commitments Cashflow scheduling the agreed projects from 2017-18 through 2022-23, Weir, Maple Grove, Henry Hudson, the Hamber auditorium, carries no Carleton line at all.1

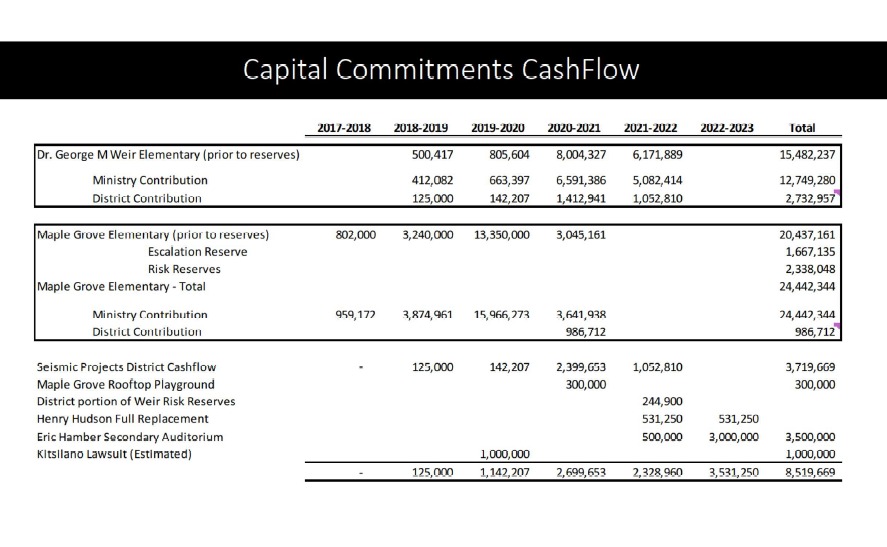

Vancouver School Board slide titled Capital Commitments CashFlow, a table of spending by fiscal year from 2017-2018 through 2022-2023 with a total column. Rows cover Dr. George M Weir Elementary and Maple Grove Elementary with their ministry and district contributions, seismic projects district cashflow, the Maple Grove rooftop playground, the district portion of Weir risk reserves, Henry Hudson full replacement, the Eric Hamber Secondary auditorium and the estimated Kitsilano lawsuit. No row names Carleton.
Capital Commitments Cashflow, 2017-18 to 2022-23, obtained with the table above. Every agreed project appears; Carleton does not.

The larger public sequence

That table was no outlier. It sat inside a larger public sequence.

In the 2019/20 capital plan materials, Carleton still appeared in the Seismic Mitigation Program list. By May 2019 the Long Range Facilities Plan recommendations included an explicit item: decide whether a seismically upgraded Carleton should serve as temporary accommodation for the seismic programme or return as an enrolling school. Later district documents state that in 2019 the Vancouver Project Office Steering Committee concluded there was no feasible business case that could be advanced to the Ministry. The Ministry did not support the project.

From that point the language hardened. Subsequent Long Range Facilities Plan updates described Carleton as unsupported in the Seismic Mitigation Program and stated that allocating district resources to restore it would be an ineffective use, because the buildings would remain high seismic risk with significant deferred maintenance. The path shifted toward alternate use and, eventually, the formal closure process under Policy 14.

The hinge

The 2016 fire is the immediate cause of the vacancy. The 2019 business-case and prioritisation decision is the hinge that turned temporary displacement into a multi-year holding pattern. Everything that followed sits downstream of that determination: the catchment reduction in 2023, the initiation of closure consideration, the pause for updated enrolment projections after provincial housing legislation, the restarted engagement in 2025, and the closure vote of 18 December 2025.2

That reading claims nothing about motives. It follows the public record, step by dated step. The same record shows other projects receiving earlier and clearer commitments while Carleton remained unresolved. The same record shows the later formal justification for permanent closure resting, in significant part, on the absence of provincial funding support that the 2019 process had already made unlikely.

Ten school years out of enrolling use, with parts of the restored site under tenancy while the fire-damaged blocks stand closed. Board-reported carrying costs accumulating across those years at approximately $65,000 a year, the figure the closure rationale itself carried as an argument for ending the vacancy, which is roughly $650,000 across the holding period at that rate.3 A final closure decision on 18 December 2025.4 All of it traces back to a prioritisation and business-case conclusion reached while the school was still formally on the books.

The 2019 decision is the origin point. The rest of the sequence is the consequence.

Next Monday: Ten Years Empty.


Vik Khanna writes The Split Record, a weekly reading of the public record on Vancouver’s school lands. He is CEO and co-founder of The Visual Thinking Company, which publishes the evidence record separately at thevisualthinkingcompany.com. The views in this series are his own. Sources for each piece are cited in the text and listed in the series index.

Sources

  1. Provenance. Capital Commitments October/November 2019 is a record of a private board meeting. It was obtained by VTCo and has not been published by the district. Its companion, Capital Commitments Cashflow, 2017-18 to 2022-23, was obtained with it. Neither appears on vsb.bc.ca. Both are reproduced above in full so that the transcription can be checked against the record.

  2. The closure process record, across two district pages. Vancouver School Board, Carleton Boundary Engagement: the Board approved the catchment boundary adjustments on 30 January 2023, reducing the Carleton catchment and expanding Cunningham, Weir and MacCorkindale. Vancouver School Board, Rationale for Closure, 2 December 2025: “The process for considering the closure of Carleton Elementary began in June 2023. However, engagement was paused to assess the impact of changes to provincial housing initiatives, changing City of Vancouver zoning conditions and the impacts these factors would have on enrolment.” The 26 June 2023 board motion to begin engagement under Board Policy 14, and the restart of public engagement on 1 October 2025, are stated in the closure announcement cited above.

  3. Vancouver School Board, Proposed closure of Sir Guy Carleton Elementary: pre-engagement, stakeholder slides, October 2025: “severely damaged by a fire in 2016 and has not been used as a school since then”, carrying “roughly $65,000 per year to keep the site boarded and safe”.

  4. Vancouver School Board, Vancouver School Board approves the closure of Sir Guy Carleton Elementary School, 18 December 2025.
